B.D. Upton Builders

QUALITY HOMES

Hungate Road - Homes Progress

Hungate Road - Homes Progress

Monday 9th January 2023

This page will show our progress through the site and its phases, so you should be able to see as and when plots are built and sold and see what kind of homes are going to be built next. If you would like to know more about any of the homes please contact us.

Phase 1

Plot Number Type of Home Sales Status
1 3 bedroom Bungalow With Garage Sold and occupied
2 3 bedroom Bungalow With Garage Sold and occupied
3 3 bedroom Bungalow With Garage Sold and occupied
41 3 bedroom Bungalow With Garage Sold and occupied
42 3 bedroom Bungalow With Garage Sold and occupied
43 3 bedroom Bungalow With Garage Sold and occupied
44 3 bedroom Bungalow With Garage Sold and occupied



The drone video overview of the site below was taken during November 2021.



Phase 2

Commenced 2022.

We have completed the set out, access and sewers for the cul de sac as part of phase 2.
We are now working on the homes in this phase.

Plot Number Type of Home Sales Status
4 3 bed bungalow with garage Sold and occupied
5 3 bed bungalow with garage Sold and occupied
6 4 bed house with large garage For Sale ↻ February 2026
7 4 bed house with large garage Sold and occupied ↻ September 2025
8 3 bed bungalow with garage Sold and occupied
39 3 bed bungalow with garage Sold and occupied
40 3 bed bungalow with garage Sold and occupied
35 3 bed bungalow with garage Sold subject to contract ↻ February 2026
36 3 bed bungalow with garage For Sale ↻ March 2026
34 4 bed house Under construction ↻ February 2026

The plots for phase 2 are marked on the diagram at the bottom of this page.

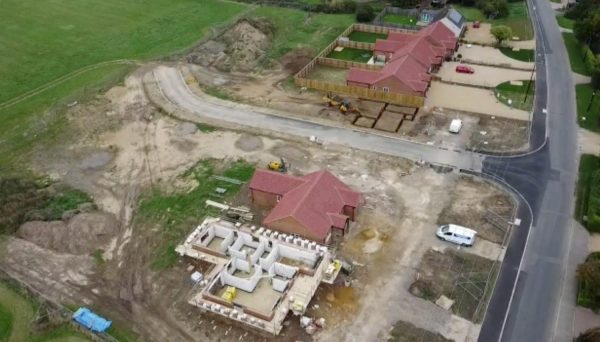

Image from drone taken over Hungate Road site in November 2021

Image from drone taken over Hungate Road site in November 2021

Plot-41 Kitchen

A completed bungalow kitchen plot 41 January 2023



Phase 3

The phases have been rejigged a bit from the earlier plan so we are starting on phase 3.

Plot Number Type of Home Sales Status
9 3 bed bungalow with garage Sold subject to contract ↻ February 2026
10 4 bedroom house Under construction ↻ February 2026
11 4 bedroom house Under construction ↻ February 2026
12 – Under construction ↻ February 2026
15 – Under construction ↻ February 2026



We hope to make plot 37 and 38 first time buyer homes via the “first home“ government scheme if and when it becomes active.

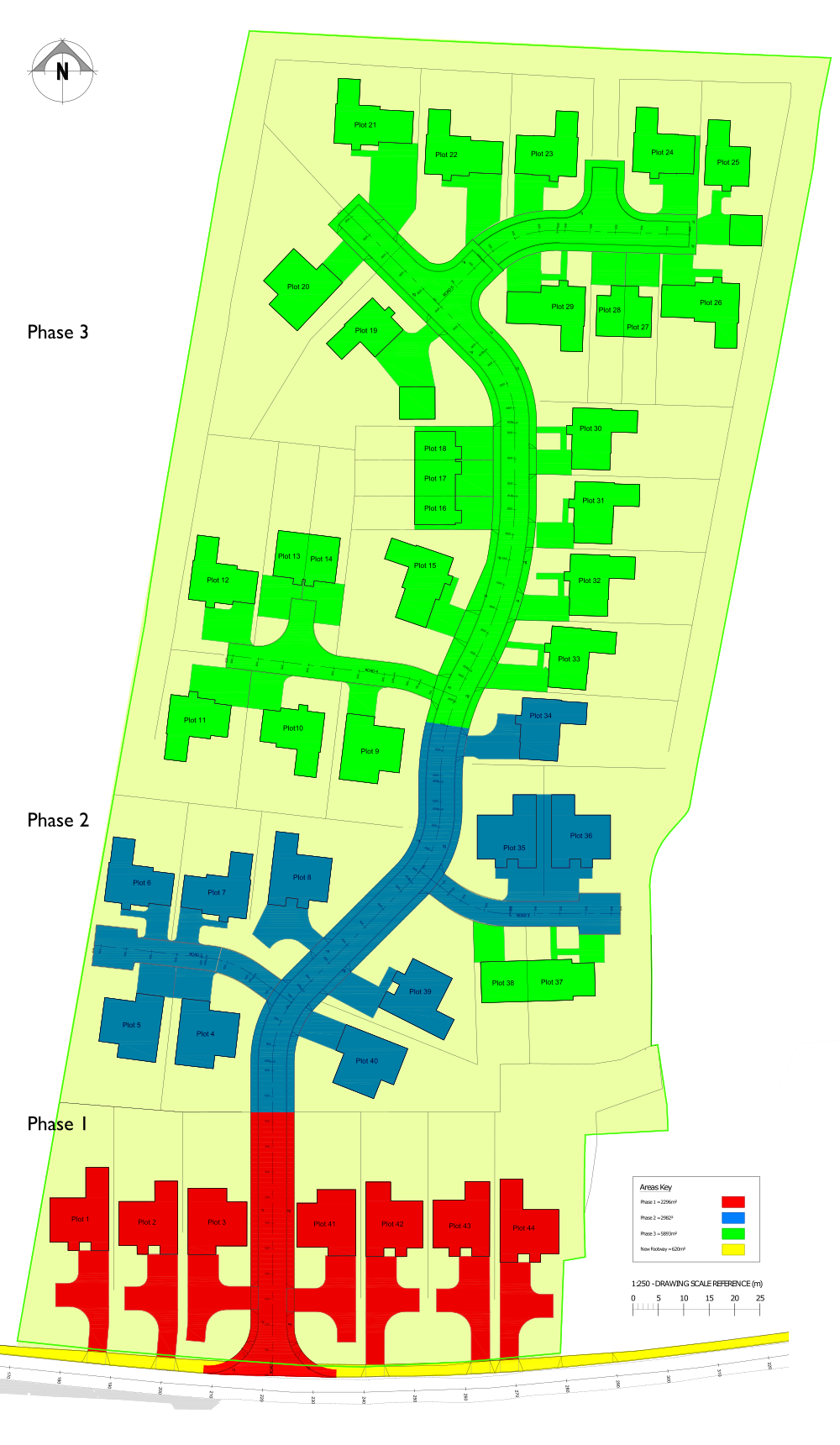

Phasing Plan - Hungate Rd - 2025

In November 2021 the pedestrian link between Gaultree Square and the playing fields running past this site was completed. It has been passed by Norfolk County Council Highways Inspector and has had a Safety Audit. Hopefully this pathway will be a benefit to the citizens of Emneth.
Pathway past Hungate Rd site in Emneth.
